FinnBUILDER® is an affordable system of house construction, commercial property construction or industrial property construction with a proven track record. FinnBUILDER cuts construction time and costs.
Follow us on Facebook and Instagram to see videos of construction in progress. Click on the buttons at the bottom of this page.
A building team utilizing 4 FinnBUILDER® moulds will complete 40m2 to 50 m2 of vertical walling a day, the equivalent of 4 000 to 5 000 ordinary stock bricks. Concrete is mixed on site. Sand and stone is sourced locally reducing costs and the carbon footprint.
.jpg?token=95ee8544bdc03f414d1c4119e14634b8)

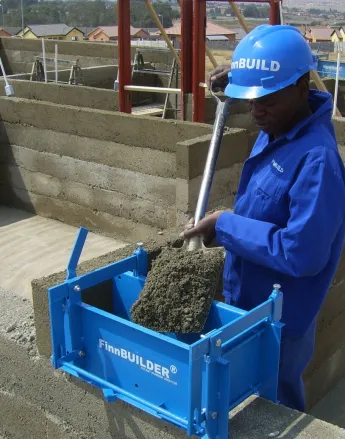

Mix sand, stone & cement to achieve the specified concrete strengths shown in our site specific rational designs.
.jpg?token=c4873f0739c560bd76824f773b4c32d7)

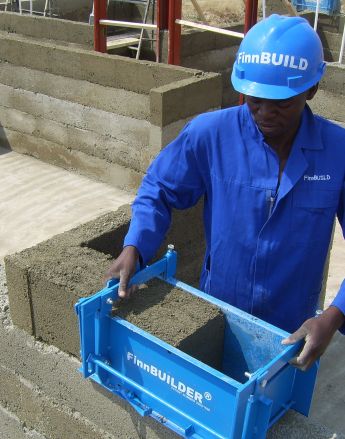

Place the concrete mix in the FinnBUILDER® mould and confirm the quality of the mix.
.jpg?token=f75339c35a707d2ed9169ad562f6a18b)

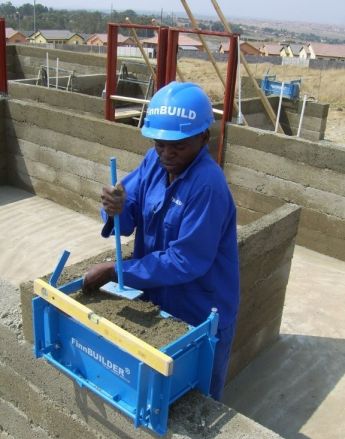

Compact the concrete in the FinnBUILDER®, level the mould and square off excess mixture using a plastic float.
.jpg?token=762afc4121faf253a4dc1af591f96186)
Depress the panel release lever to release the side panels and move the FinnBUILDER® mould forward leaving a wet concrete wall behind.
The mixture used is varied depending on what is to be built, the cost and availability of materials in the locality of the proposed site. The Detailed Construction Guide packaged with the machines, gives 17 different concrete mixes that can be used depending on the application.
For general planning purposes, a generic mix of 2 parts 13mm concrete stone; 4 parts river sand; 2 parts building sand and 1 part cement can be used.
One and a half hours. So if a FinnBUILDER® Operator starts building at 07h30 from point A, and reaches point B at 09h00, he can immediately come back to point A and start his second row of the day at 09h00. It follows that he will start the third row at 10h30, the fourth at 12h30 after lunch, the fifth at 14h00 and the sixth at 15h30.
As soon as the concrete is compacted and the FinnBUILDER® has been levelled, the mould can immediately be moved forward. This normally takes between two or three minutes.
About 15m2 of vertical walling a day. A Trainee will complete about 5m2 a day and progress over time to 15m2. By comparison a bricklayer will do about 7m2 of vertical walling a day (800 bricks per day).
Yes. FinnBUILDER supplies a site speciifc rational design for each unit based on the specifics of our technology.
Yes. Based on the accreditation of the FinnBUILDER® system by the NHBRC, all local authorities in South Africa will approve building plans. The process is that Building Plans must be submitted with the currently dated FinnBUILDER Certificate of Licence of the Licenced FinnBUILDER Contractor. Building plans are also being approved in other countries based on this accreditation of the NHBRC
Yes. All major Banks in South Africa are granting buildings loans for new homes to be built with FinnBUILDER® technology. This must incorporate our site specific rational design, our QMS, on site inspections by FinnBUILDER inspectors who issue a certificate of compliance on completion and overall sign off by the appointed Engineer.
Customers make a payment and the moulds are delivered door to door within 3 to 5 working days in South Africa. International deliveries take 7 to 14 days. Customers can also visit our Showroom, make payment (cards or EFT) and collect the moulds.
We do not have Branches. Instead product is delivered from our Showroom in Johannesburg directly to Customers door to door.
It is slip-form concrete shuttering using no-slump reinforced concrete. The strength of the concrete is varied from 5 MPa to 30 MPa depending on structural requirements detailed in the FinnBUILDER® site speciifc rational design.
FinnBUILDER® Note
Walls to be built with FinnBUILDER® moving shuttering as per site specific rational design supplied by FinnBUILDER® and constructed by a certified specialist (Licensed FinnBUILDER Contractor who can produce their currently dated Licence to confirm their accreditation).
This depends on which of the 17 concrete mixes is specific for the site speciifc rational design. However for general planning purposes the following ratios can be used as a guide for 110 mm wide wall;
| Material | Mix | Quantity per m2 wall |
| 13 mm Stone | 2 parts | 0,033 m3 |
| River sand | 4 parts | 0,066 m3 |
| Building sand | 2 parts | 0,033 m3 |
| Cement | 1 part | 21 kgs |
Yes, both usb (under surface bed construction plastic) and dpc (damp proof course) are used.
Yes, both brickforce and high tensile steel reinforcing is used and will be specified in the FinnBUILDER® site specific rational design.
Yes. We send a site specific rational design for the structure to the Licensed FinnBUILDER® Contractor which specifies the materials, concrete mix, concrete strength, width of walls, reinforcement, ring beams, slab detail, roof fixing detail etc. This is used to enrol the site with the NHBRC and followed in construction. FinnBUILDER® inspects the structure and issues a COC (certificate of compliance) on successful completion to the Engineer of record, the Builder and the Owner.
